Structural Modeling and Analysis of Causes of Cost Overruns in Oil and Gas Projects in Kazakhstan



Cite item

Full Text

Abstract

Aim: The objective of the study is to analyze the relationship between resource-related factors, such as labor, equipment, and material factors, and cost overruns in the oil and gas projects in Kazakhstan.

Materials and methods: A structured survey consisting of 15 resource-related risk factors was distributed to experienced professionals working in the oil and gas sector. A total of 172 valid responses were gathered. The data were evaluated using descriptive statistics, econometric methods and partial-least squares structural equation modeling (PLS-SEM) to assess reliability, validity, causal relationships, and regressed variables.

Results: The empirical analysis shows that labor-related risks, including labor shortages, low productivity, and labor incompetence, have the most substantial and statistically significant impact on cost overruns. Material-related and equipment-related risks demonstrate a moderate yet meaningful effect. All three latent constructs exhibit internal consistency and convergent validity. Furthermore, change orders and financial difficulties are also strong contributors to cost escalations.

Conclusion: The study concludes that effective resource planning is critical for minimizing cost overruns and ensuring the successful execution of oil and gas projects in Kazakhstan. Improving workforce competency, enhancing material supply reliability, and efficiently providing physical resources are recommended practices for overall project management body of knowledge.

Full Text

INTRODUCTION

The oil and gas industry of the Republic of Kazakhstan has been the most rapidly developing and capital-intensive since the country attained independence. The nation's economic development is hugely dependent upon the industry trends including cyclical variations in oil prices and global and local recessions. Therefore, stakeholders’ primary role lies in creating effective mechanisms for attracting foreign investments and ensuring a favorable environment for the implementation of oil and gas projects.

Numerous oil and gas projects worldwide are associated with risks that result in either delays in timely completion, increased project costs, or both. Merrow (2012) indicates that merely 22% of projects are deemed successful, while 78% of projects experienced verified budget overruns of 33% and completion delays of 30% [1]. Although not formally recorded, oil and gas projects in Kazakhstan also experience time delays and cost overruns that significantly affect their overall success and financial feasibility.

Recently, Offshore Technology journal cited Bloomberg and reported that the Tengiz Future Growth Project would face an additional 1.5 billion USD in costs, bringing the total cost to approximately 48.5 billion USD, compared to the initially approved price of $37 billion [2]. Furthermore, the project was originally scheduled for completion by mid-2022, but has been postponed twice, and has been actually launched in the first quarter of 2025.

In this context, Project Management Institute defines resources as project personnel, equipment required to execute activities, and materials necessary to complete the project deliverables [3]. Each resource type may pose unique challenges that lead to cost overruns. Labor shortages, machine malfunctions, and material supply difficulties are prevalent obstacles that can impede project progress. Consequently, understanding causes that result in cost overruns is essential for the successful completion of projects.

Chanmeka et al. indicated that inadequate planning and poorly specified project scope are significant factors leading to schedule and cost performance challenges in oil and gas projects in Alberta, Canada [4].

Shash and AbuAlnaja recently identified 23 factors influencing material availability and highlighted that material delays, mistakes in design and binding documentation, poor estimation, and material cost inflation are the predominant and critical determinants of low performance in Saudi Arabian oil and gas projects [5].

Extensive research studies have categorized causes into client (or owner), contractor, consultant, labor, equipment, material, financial, and external-related factors [6, 7, 8].

Syzdykov, Seitimov, and Baibussinova have emphasized the importance of resource-related risks in Kazakhstani oil and gas industry. Their proposed approach utilized qualitative (expert assessments) and quantitative (relative index) methodologies to systematically classify and address risk factors [9].

The aim of this study is to further evaluate complex relationships between resource variables, their dependencies via latent constructs, and the potential effects on cost overruns. Partial Least Squares Structural Equation Modeling (PLS-SEM) is employed to analyze and model the relationships between identified risks and their constructs on project cost overruns.







MATERIALS AND METHODS

The study employed a quantitative method to examine the impact of resource-related risk factors on project cost management. Comprehensive literature review revealed 11 factors related to resources and 4 factors that frequently cause direct project cost overruns.

The questionnaire was subsequently designed and distributed to project managers, supervisors, and technical teams via an online Google Form application. The survey was administered to a targeted group of individuals with extensive experience in project management.

Participants were requested to assess the impact of risks using a five-point Likert scale, with 0 denoting “none”, 1 indicating “mild”, 2 – “moderate”, 3 – “severe”, and 4 signifying “very severe” impact. The risks factors were not categorized into latent constructs since the research aimed at conducting confirmatory factor analysis by structural equation modeling.

R programming language was used to conduct the partial-least squares structural equation modeling and interpretation of survey data, including reliability and validity tests.



Econometric Model and Hypotheses Formulation

The main research question of the study is to evaluate the effect of resources, such as equipment, labor, and materials, as well as the causes associated with them on project cost overruns in the oil and gas industry. The econometric relationship of project cost overrun (the dependent variable) and equipment, labor, materials (independent variables) can be expressed as the following main regression model in a general form is as follows:





(1)

where:

 – cost overrun (latent dependent variable),

 is an intercept term,

, ,  and  are regression coefficients for each construct in a model,

, ,  – equipment, labor, and material latent constructs, respectively,

 is an error term, accounting for unexplained variance.

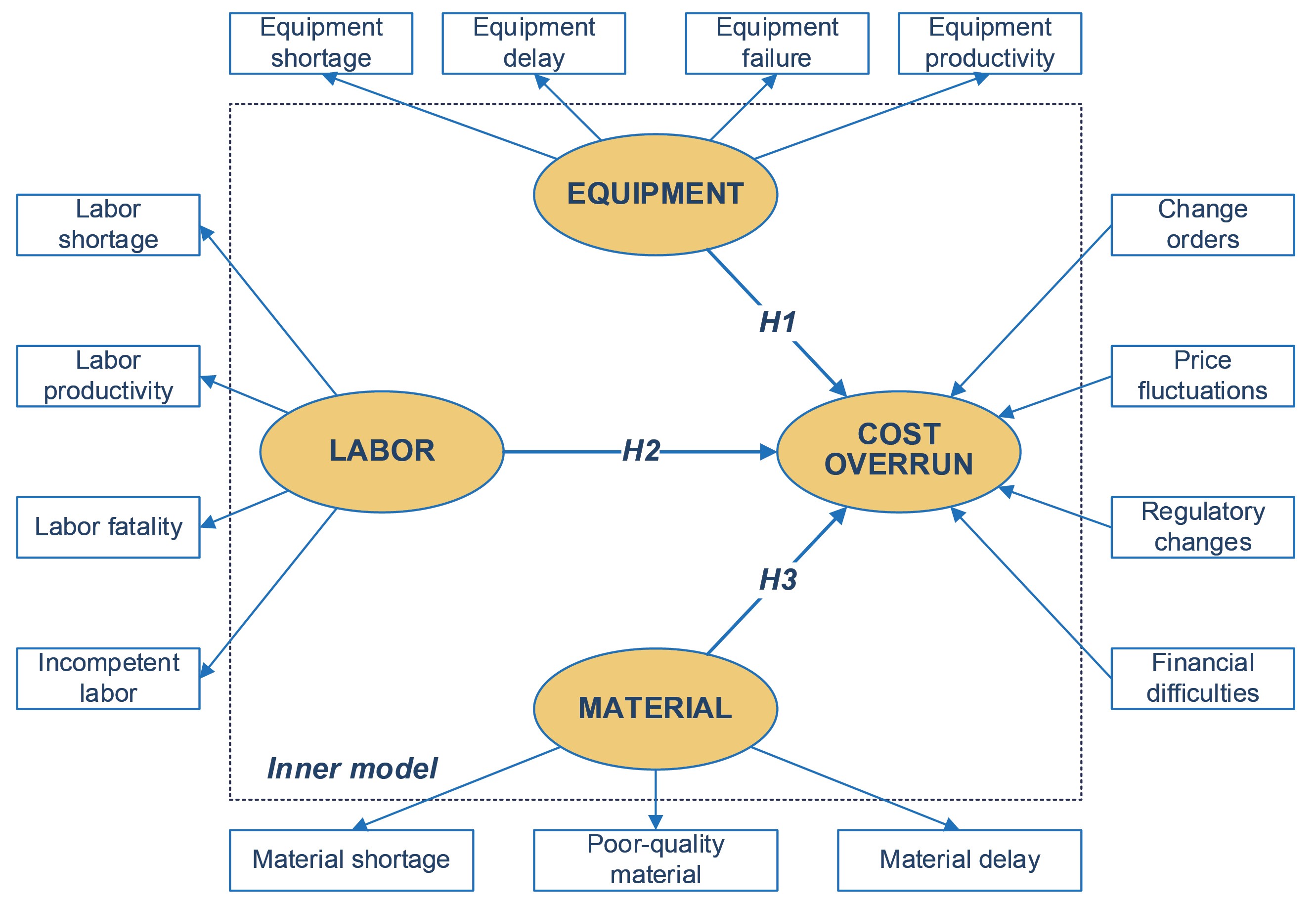

Figure 1 illustrates the comprehensive research framework. The golden-hued oval shapes seen in the Figure represent latent constructs. Eleven arrows extend from equipment, labor, and materials constructs, primarily indicating the reflective measurement models. On the right side, four inward arrows representing change orders, price fluctuations, regulatory changes, and financial difficulties converge on the cost overruns, which show their formative measurement model. The inner structural equation model, comprising of latent constructs, delineates the primary hypotheses to be examined in this study:

H1: Equipment-related resource factors have a positive effect on project cost overruns.

H2: Labor-related resource factors positively influence project cost overruns.

H3: Material-related resource factors have a positive effect on project cost overruns.







Figure 1. Relationships between resource-related factors and the cost overrun





RESULTS

Demographic information

The study results cover a diverse group of 172 respondents classified by their occupational roles and industrial experience. The companies’ roles are categorized into three primary groups: clients (69 individuals), contractors (61), and consultants (42). Table 1 presents detailed information regarding the respondents.



Table 1. Demographic characteristics of respondents

Categories

Company Role

Client

Contractor

Consultant

Job

Classification

Engineering / Design

34

33

32

Project Management

24

18

4

Supervisory / Management

11

10

6

Industry

Experience

less than 5 years

12

20

6

5 - 9 years

15

18

16

10-14 years

22

14

6

15-24 years

13

6

8

25 years and more

7

3

6

According to Table 1, a significant portion of respondents, 57.56%, are involved in engineering and design jobs. This category comprises 34 clients, 33 contractors, and 32 consultants. The category with the least representation is supervisory and management, including 27 respondents or 15.7%. Considering industrial experience, 28.49% of respondents possess 5-9 years, while 24.42% have 10-14 years of experience.



Reflective Measurement Models Evaluation

This subchapter presents a thorough assessment of reflective measurement models for three constructs: equipment, labor, and material. Equation (2) depicts the relationship of each measured variable to the equipment latent construct.



(2)

where:

, , , and  represent  observation of each observed variable in the equipment latent construct,

, , , and  represent the factor loadings for each measured variable,

 denotes the residual error associated with the construct.

Similarly, Equations (3) and (4) define labor and material constructs, respectively:



(3)



(4)

Equations (3) and (4) replicate the structure of Equation (2) wherein each measured variable is linked to its corresponding latent construct via factor loadings, while residual errors account for unexplained variance.



Furthermore, the constructs are assessed using essential statistical measures to determine the model’s reliability and validity (see Table 2).





Table 2. Assessment of Reliability and Validity in Reflective Measurement Models



Construct

Item

Factor

loadings

Cronbach's

alpha

Composite

reliability

AVE

Equipment

Shortage

0.869

0.896

0.927

0.762

Delay

0.838

Failure

0.881

Productivity

0.901

Labor

Shortage

0.789

0.854

0.902

0.697

Productivity

0.889

Fatality

0.780

Incompetency

0.864

Material

Shortage

0.927

0.889

0.931

0.818

Poor-quality

0.907

Delay

0.880



Indicator reliability

The initial step involves verification of individual factors’ reliability. Factor loadings ( ) denote the strength of each variable and its corresponding construct. Moreover, factor loadings must exceed the threshold value of 0.7 to validate indicators’ reliability.

Table 2 demonstrates that the equipment construct has factor loadings between 0.838 (equipment delay) and 0.901 (equipment productivity), whereas the labor construct shows loadings from 0.780 (labor fatality) to 0.889 (labor productivity). The stronger relationship between variables and the construct is seen in the material category, where loadings vary from 0.880 (material delay) to 0.927 (material shortage).



Internal consistency reliability

Cronbach's alpha evaluates the internal consistency of indicators within each construct, with values exceeding 0.7 being acceptable. The current study reports Cronbach’s alpha values of 0.896, 0.854, and 0.889 for the equipment, labor, and material constructs, respectively, indicating high internal reliability.

Composite reliability (CR) also evaluates the overall reliability of the construct and its indicators, and it is often preferred over Cronbach’s alpha. For instance, composite reliability scores of 0.927 for equipment, 0.902 for labor, and 0.931 for material constructs confirm robust consistency reliability among the individual loadings.



Convergent validity

The next step in assessing the reflective measurement model is to verify convergent validity. Average Variance Extracted (AVE) is a standard measure that quantifies the variance extracted by a construct from its indicators in relation to the variance attributed to measurement error. An AVE value exceeding 0.5 is deemed acceptable. Three constructs demonstrate sufficient explained variances of 0.762 (or 76.2%) for equipment, 0.697 (or 69.7%) for labor, and 0.818 (or 81.8%) for materials.





Formative Measurement Model Evaluation

Unlike the reflective measurement model, independent variables cause or form the dependent construct in a formative measurement model. This approach is widely used when multiple factors define the construct rather than describing it reflectively.



(5)

where:

, ,  and  are change orders, price fluctuations, regulatory changes, and financial difficulties of  observation, respectively,

 is an intercept,

, ,  and  are outer weights of the formative indicators,

 is a residual error term of the formative measurement model.

Table 3 presents outer weights and loadings of the formative measurement model. For validity, outer loadings must exceed 0.5. The table indicates that all variables have outer loadings over 0.5. The outer weights are assessed for validity and reliability using the bootstrapping technique in PLS-SEM.







Table 3. Outer Weight Evaluation

Relationship

weights

loadings

communality

Change orders -> Cost overrun

0.407

0.793

0.629

Price fluctuations -> Cost overrun

0.132

0.772

0.596

Regulatory changes -> Cost overrun

0.279

0.820

0.672

Financial difficulties -> Cost overrun

0.426

0.815

0.664



Table 3 demonstrates that outer weights signify the strength of an impact of independent variables on cost overruns. Financial difficulties and change orders exert the strongest influence on cost overruns, with outer weights of 0.426 and 0.407, respectively.

Price fluctuations exert minimal influence on project cost overruns, as seen by its negligible outer weight (0.132). Regulatory changes, such as those changes in government policies, compliance requirements, and legal regulations, are usually overlooked. This study confirms that they might have a moderate influence on overruns (outer weight = 0.279).



PLS-SEM Results

To effectively evaluate the structural equation model, it is recommended first to verify the absence of collinearity issues among exogenous and endogenous variables. The assessment of multicollinearity can be conducted using the variance inflation factor.



Table 4. Collinearity Statistics of the Inner Model

Hypothesis

Construct relationships

VIF

H1

Equipment -> Cost overrun

2.791

H2

Labor -> Cost overrun

2.383

H3

Material -> Cost overrun

2.808



Table 4 indicates that the latent constructs of equipment, labor, and material exhibit VIF values of 2.791, 2.383, and 2.808, respectively, in respect to the endogenous variable of cost overrun. This shows a moderate level of multicollinearity, which is acceptable and a far below the cutoff value of 5.

The heteroscedasticity test is the subsequent step in validating the reliability of statistical reasoning. Heteroscedasticity can lead to erroneous model predictions and undermine regression results.

This study conducted heteroscedasticity tests utilizing using both Breusch-Pagan and White’s approaches. In the initial test findings, the Breusch-Pagan statistic (BP) was 6.7966 with 3 degrees of freedom (df) and a p-value of 0.07867, while White's test produced a BP of 6.9657 with 6 df and a p-value of 0.324. The p-values for both tests exceed the significance level of 0.05, thus indicating the absence of heteroscedasticity.







Regression Analysis

The independent latent constructs were regressed on the dependent latent construct, which was the cost overruns. The primary objective of the regression analysis is to assess the direct relationships between the latent constructs and their statistical significance.

Table 5 captures the results of regression analysis, with each column representing coefficient estimates, standard errors, t-values and p-values.



Table 5. Hypothesis Testing and Evaluation of Structural Model

Item

Relationships *

Path coefficient

Std. Error

t-values

p-values

Decision



(Intercept)

2.085e-17

0.0517

0.000

1.000



H1

Equipment -> Cost overrun delay

0.180

0.0863

2.090

0.0381

supported

H2

Labor -> Cost overrun

0.454

0.0798

5.694

5.43e-08

supported

H3

Material -> Cost overrun

0.177

0.0866

2.044

0.0425

supported

Residual standard error: 0.6777 on 168 degrees of freedom

Multiple R-squared:  0.5515,  Adjusted R-squared:  0.5435

F-statistic: 68.85 on 3 and 168 DF, p-value: < 2.2e-16



Equation (1) can be rewritten as follows, using the values obtained from the regression analysis:



(1*)

Each path coefficient in the regression equation (1*) denotes the impact of latent construct on the cost overruns. The path coefficient ( ) indicates that a one-unit increase in equipment leads to a 0.180-unit rise in cost overruns. Nonetheless, this effect may be statistically questionable, as the p-value of 0.0381 is proximate to 0.05. It can be asserted that the alternative hypothesis H1 is validated at the 0.05 significance level.

The labor coefficient  is statistically significant (p-value << 0.001), indicating that a one-unit increase in labor causes a 0.454-unit increase in cost overruns, assuming all other variables are held constant.

The material construct (p-value < 0.05) has a path coefficient  suggesting that, ceteris paribus, a one-unit increase results in a 0.177-unit increase in cost overruns.



DISCUSSION

The findings of this study has shed light on the impact of resource-related factors on project cost overruns. In the latest paper, Dong et al. (2025) identified project resource-supply challenges as principal factors in cost escalation. The authors highlighted the shortage of skilled labor, equipment and material supply as significant issues [10].

This study also show that labor productivity and competency issues have the strongest effect on cost overruns ( ) followed by material shortage and equipment productivity. This finding is consistent with Nguyen et al. (2024), who pointed out that physical project resources are one the five critical risk factors contributing both to cost and schedule overruns. Their analysis also emphasized design changes and financial challenges similar to the current study [11]. Furthermore, Nuako et al. (2024) have identified the capability and competency of project teams as a critical success factor for reducing overruns in public construction projects [12]. Our finding that material shortages and delays substantially lead to cost overruns agrees with Nuako et al.’s assertion regarding the necessity of timely payments to ensure stable supply chains.

Another recent study by Mosly (2024) reports that labor productivity, workforce competency, and contractor performance are among the leading determinants of construction cost escalation in Saudi Arabia [13]. Our findings are consistent with this – labor shortages, low productivity, and lack of competency exert the strongest direct impact on cost overruns. Mosly also indicated that managerial decisions and financial discipline are systematic challenges of cost growth. Therefore, poor planning in a form of change orders must be avoided by project managers.

The current study results also replicate the findings reported by Islam, Nepal, and Skitmore (2023), who stated that resource-related issues, such as a lack of skilled labor, materials supply difficulties, and equipment availability, were to increase cost growth and schedule delays in power plant projects [14].

The findings of this study align with those of Sohrabi and Noorzai (2023), who indicated that resource-related risks are significant factors in project underperformance within the Iranian oil and gas construction sector [15]. Our results also reveal that labor-related risks have the strongest impact on cost overruns and highlight that human capital is the key factor in sustaining productivity and cost control in complex oil and gas settings.



CONCLUSION

The study has analyzed the effects of resource-related risks on the within-budget completion of oil and gas projects. This study employed an advanced research methodology, especially PLS-SEM and focused exclusively on resource-associated risks. All resources, including equipment, personnel, and materials, are equally vital to the project’s success. Our findings demonstrate that labor is the principal factor exerting the most significant influence on project cost performance. As a result, the current study delivers an essential message to the oil and gas sector and project managers regarding the need for competent workforce. Ensuring workplace competency requires trainings and improving communication and collaboration across divisions.

Although the two other alternative hypotheses regarding equipment and material-related risks were comparatively moderate, they remained statistically significant. This suggests that equipment and material latent variables are also decisive resource-related factors. In addition, the analysis confirmed that change orders and financial difficulties directly affect cost overruns, while price fluctuations did not show a strong effect. Overall, the study emphasizes that minimizing cost overruns in oil and gas projects requires qualified workforce development, careful resource planning, and effective change management.

×
